Gantt view

Gantt adds a timeline beside the Operon Table, so you can compare task fields and plan their dates in the same place. The Table remains on the left and the Gantt timeline opens on the right, with each task row aligned to its bar, date markers, and dependency lines. It is not a separate Operon view or command: it is another way to work with the rows of the current Table preset.

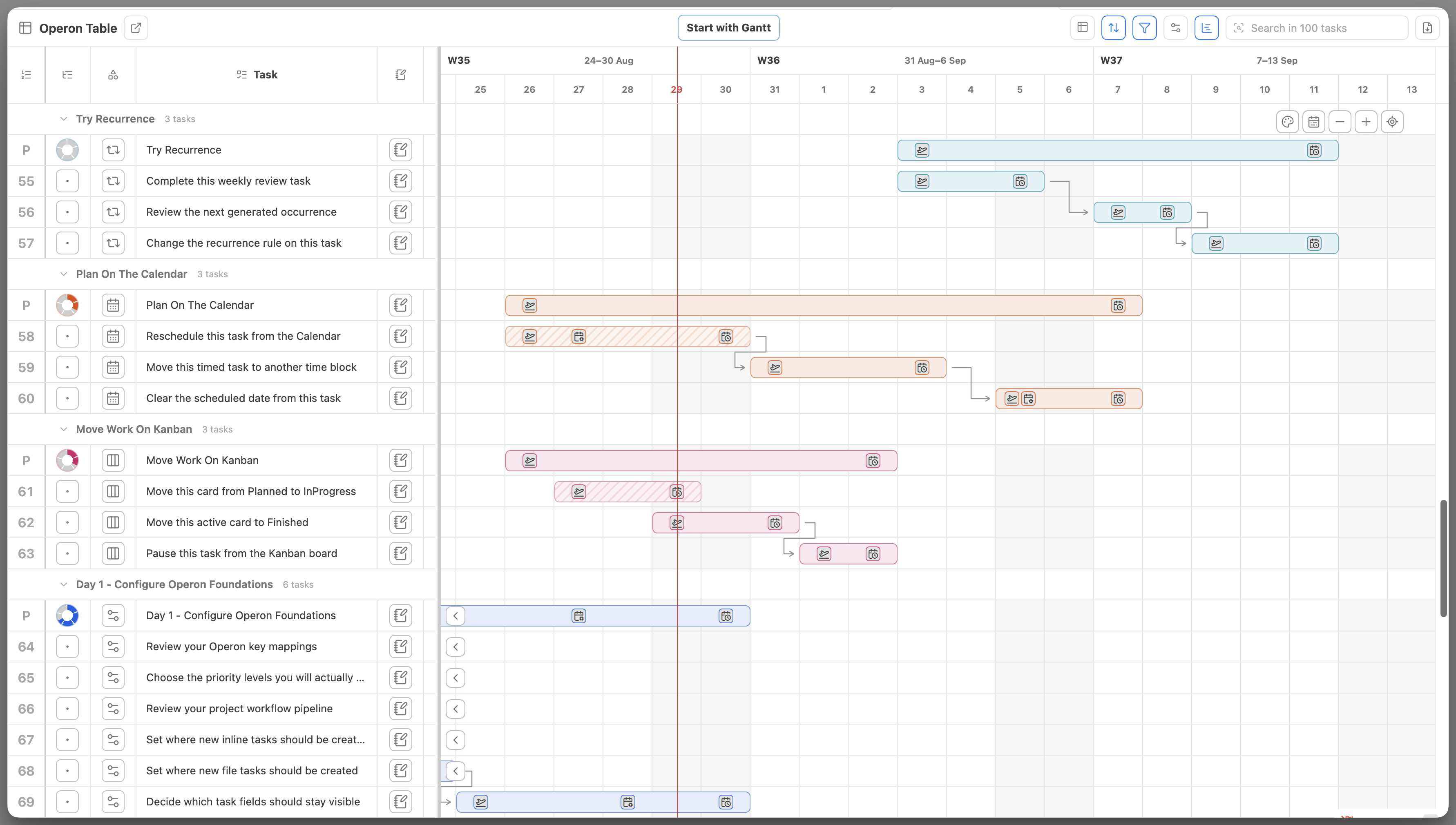

MEDIA-DOCS-139-1: A typical Gantt opened beside an Operon Table, with task rows on the left and aligned dated bars, dependency lines, and the timeline scale on the right.

MEDIA-DOCS-139-1 - A Gantt timeline beside an Operon Table

Use Gantt when the question is not only when is this task?, but also how long does it run, what comes before it, and what moves with it? The Calendar is still the better surface for shaping a day or week around timed blocks. Gantt is for seeing a sequence of work across a longer timeline while keeping the Table's columns, grouping, sorting, and task hierarchy in view.

Open and arrange Gantt

Open an Operon Table, then select Gantt View in the Table toolbar. The same button closes the timeline and returns the Table to its full width. The current Table preset decides which tasks and rows appear; opening Gantt does not create another filter or duplicate the tasks.

Drag the divider between the Table and timeline to change how much width each side receives. On touch-oriented devices, the divider has a wider grab area without becoming visually wider. Vertical scrolling stays shared, so a Table row and its Gantt lane remain aligned. Hovering a row on either side also highlights its matching row on the other side.

The toolbar setting and divider position belong to the current Table preset. A preset can therefore open as a normal full-width Table or open with its Gantt timeline already visible. See Table presets.

How task dates become bars and markers

Gantt reads the same task fields used by the rest of Operon:

  • A task with dateStarted and dateDue becomes an all-day range bar from the start date through the due date.
  • A task with datetimeStart and datetimeEnd becomes a timed range bar when it does not already have an all-day start-to-due range. If datetimeEnd is empty but the task has an estimate, Operon can use that estimate to determine the effective end.
  • A task with only dateScheduled becomes a one-day scheduled bar.
  • Start, scheduled, and due dates can also appear as separate icons when their global marker settings are enabled.

Each visible date marker opens its matching date picker when clicked or tapped. Dragging the marker moves only that date field, leaving the task's other dates unchanged. With touch or pen, press and hold a marker before dragging it. On fine-pointer devices, a marker inside a bar can stay quiet until hover or keyboard focus; on touch-oriented devices, date markers and editing controls remain visible with larger grab areas.

Task dates in bar and marker tooltips follow Settings → Operon → Core → General → Language & Formats → Date format. Timeline day, week, and month headers remain locale-based and are not reformatted by that setting.

A task without any usable Gantt date still keeps its row. Its empty timeline lane is where you can give it a date directly.

Add dates from an empty lane

Click an empty point in an undated task's timeline lane to place the task on that day. The global One-day click behavior decides what one click writes:

  • Set scheduled date writes dateScheduled.
  • Set start and due dates writes a one-day dateStarted to dateDue range.

Drag across more than one day in the empty lane to create a start-to-due range. The preview shows the proposed bar before the dates are written.

With touch or pen, a tap keeps the one-day action, while press-and-hold followed by a drag creates a range. Movement before the drag activates scrolls the timeline instead. Mouse and trackpad keep their existing click-and-drag behavior.

Move and resize bars

Drag the middle of a bar to move it without changing its duration. Drag the start or end handle to change that edge of the range.

With touch or pen, press and hold the body of a bar before moving it. Movement before activation scrolls the timeline horizontally or the aligned rows vertically. Resizing starts only from the visible start or end controls, which stay available with larger touch targets on touch-oriented devices. Mouse and trackpad interactions are unchanged.

  • Moving a scheduled bar changes its scheduled date.
  • Moving an all-day range shifts its start and due dates by the same number of days.
  • Moving a timed bar shifts its calendar dates while preserving its time of day and duration.
  • Resizing a scheduled or timed bar can promote it to an explicit start-to-due range, because the resized result now describes more than one date boundary.

When an all-day range moves, a scheduled date or timed block already contained inside that range moves with it. Dates outside the range are not pulled along accidentally.

A click that does not become a drag follows the configured Bar left-click action. The available actions are no action, open Task Editor, go to source, or open the contextual menu. The right-click action is configured separately. See Task Editor and Contextual menu actions.

Move open descendants with a parent

When Move open descendants with parent tasks is enabled, moving a parent bar also shifts the existing dates of its open descendants by the same number of days. Operon follows the task hierarchy, so direct children and deeper open descendants stay in the same relative schedule.

Only dates that already exist are shifted. Completed and cancelled descendants are left unchanged. Resizing a parent does not move descendants; the option applies when the complete parent bar moves.

Operon validates the hierarchy and all affected task sources before keeping the move. If a task changed, a duplicate identity makes the hierarchy ambiguous, or one of the writes cannot be completed safely, the combined move is rejected or recovered instead of deliberately leaving only part of the family shifted. See Parent and sub-tasks.

Move open blocked tasks with a blocker

When Move open blocked tasks with their blockers is enabled, moving a blocker bar shifts the existing dates of every open task it blocks, following the dependency chain. Each affected task moves by the same number of days, so a connected sequence keeps its relative schedule.

Only dates that already exist are shifted. Completed and cancelled tasks are left unchanged, and resizing a blocker does not move the chain. This setting follows dependency relationships; the descendant setting above follows parent-task hierarchy, so each can be enabled for the planning relationship you use.

Read and create dependencies

Dependency lines show the order between tasks that already use Operon's Blocking and Blocked By relationships. A line runs from the preceding task to its follow-up task. These are real task relationships, not drawing-only arrows.

Each eligible bar has two dependency ports:

  • The Preceding task port represents work that must come before this task.
  • The Follow-up task port represents work that follows this task.

Drag from one port to the opposite port of another task to create a dependency between two existing tasks. Gantt rejects an invalid target, including a task linked to itself or a relationship that would make the dependency graph unsafe. An existing relationship is not duplicated.

Click a dependency port instead of dragging it to open Task Creator for a new linked task. Clicking Preceding task creates work before the current task; clicking Follow-up task creates work after it. The new task uses the normal Task Creator workflow and is connected only after creation succeeds. See Task Creator.

On touch-oriented devices, dependency ports stay visible with larger touch targets. A tap keeps the linked-task creation action; dragging from the same explicit control creates a dependency.

The controls above the timeline change how the current preset is displayed:

  • Previous task date and Next task date jump toward task dates outside the current visible range.
  • Change timeline scale switches between Day – Week and Week – Month headers.
  • Zoom out and Zoom in change the width of timeline units without changing task dates.
  • The color control cycles the bar color source: no color, task, status, priority, or random colors.
  • Today places the current date near the first fifth of the visible timeline, leaving roughly four fifths of the space for upcoming work.

The same forward-looking placement is used when Gantt is configured to focus Today on first opening. The timeline can show weekend shading and a Today indicator. Gantt keeps the date around your current viewport stable while its scale, width, or surrounding Table layout changes, so changing the presentation does not intentionally send you to another part of the schedule.

Preset settings and global settings

The current Table preset stores the parts that define this particular Table and Gantt layout:

  • Whether Gantt opens by default.
  • The Table pane width in the split.
  • The Day–Week or Week–Month timeline scale.
  • The timeline unit width.
  • The bar color source.
  • Whether weekend shading is shown.

Global settings under Settings → Operon → Views → Gantt provide defaults for new Table presets and behavior shared across Gantt timelines. They include the initial split, scale, and unit width; start, scheduled, and due marker visibility; whether the first opening focuses Today; bar click actions; one-day click behavior; whether open descendants move with a parent; and whether open blocked tasks move with their blockers.

Changing a global default does not rewrite an existing preset's saved layout. Preset-specific values continue to belong to its .table file. See Table files.

Gantt in an embedded Table

An operon-table code block uses the same Table preset and can open the same Gantt split inside a note. Its rows, task dates, interactions, dependencies, and preset controls follow the same rules as the workspace Table. The note controls the embed's available area, but it does not create a separate Gantt configuration. See Embed a table in a note.

When a change cannot be kept

Gantt previews a move or dependency while you drag, but the task's Markdown remains the source of truth. If validation blocks the change or the source changed before the write completed, Operon removes the preview and restores the current indexed result. A failed parent-and-descendant move does not silently count as a successful partial schedule.

If a bar returns to its previous position, reopen the task and check its current dates, parent relationship, dependency state, and whether another edit changed the same source. For general index checks, see Missing tasks.

Tips

Start with the Table question, then open its timeline

Build the Table preset around one set of work, such as a project, release, or campaign. Add the columns and hierarchy you need, then open Gantt to schedule that same result. The Table explains what each row is; Gantt explains when it happens and what it depends on.

Use dependencies for order, not for every relationship

Link tasks when one genuinely must precede another. Use parent and subtask relationships for hierarchy. Keeping those meanings separate makes both the Task Tree and Gantt easier to read.

FAQ

Is Gantt a separate Operon view? No. It opens inside the current Table and uses that Table preset's rows, filter, grouping, sorting, and saved Gantt layout.

Why does a task have a marker but no long bar? A single scheduled date can produce a one-day bar or marker, while a longer bar needs a start-to-due range or a timed range.

Does dragging a bar change my Markdown? Yes. A successful move or resize writes the resulting dates back to the task, so the same schedule appears in Calendar, Task Editor, and other Operon surfaces.

Why did moving a parent also move other tasks? The global Move open descendants with parent tasks setting shifts dated, open descendants with a moved parent. Disable it if parent dates should move alone.

Why did moving a blocker also move later tasks? The global Move open blocked tasks with their blockers setting shifts dated, open tasks along that dependency chain. Disable it if each dependency-linked task should keep its own dates.

Can I use Gantt in a note? Yes. Embed the Table preset with an operon-table code block; the embedded Table supports the same Gantt mode.

Settings

Global Gantt behavior lives in Settings → Operon → Views → Gantt:

  • New Preset Defaults sets the initial split, scale, and unit width for new presets.
  • Date Markers controls start, scheduled, and due markers.
  • Opening and Click Actions controls Today focus and bar interactions.
  • Move Related Tasks controls moving open descendants or open blocked tasks with the task being moved.

The current Table preset's saved Gantt layout is edited through Edit preset from the Table toolbar or from Settings → Operon → Views → Tables.
